This week’s lesson combines advice from a few folks to build skills around project scheduling.

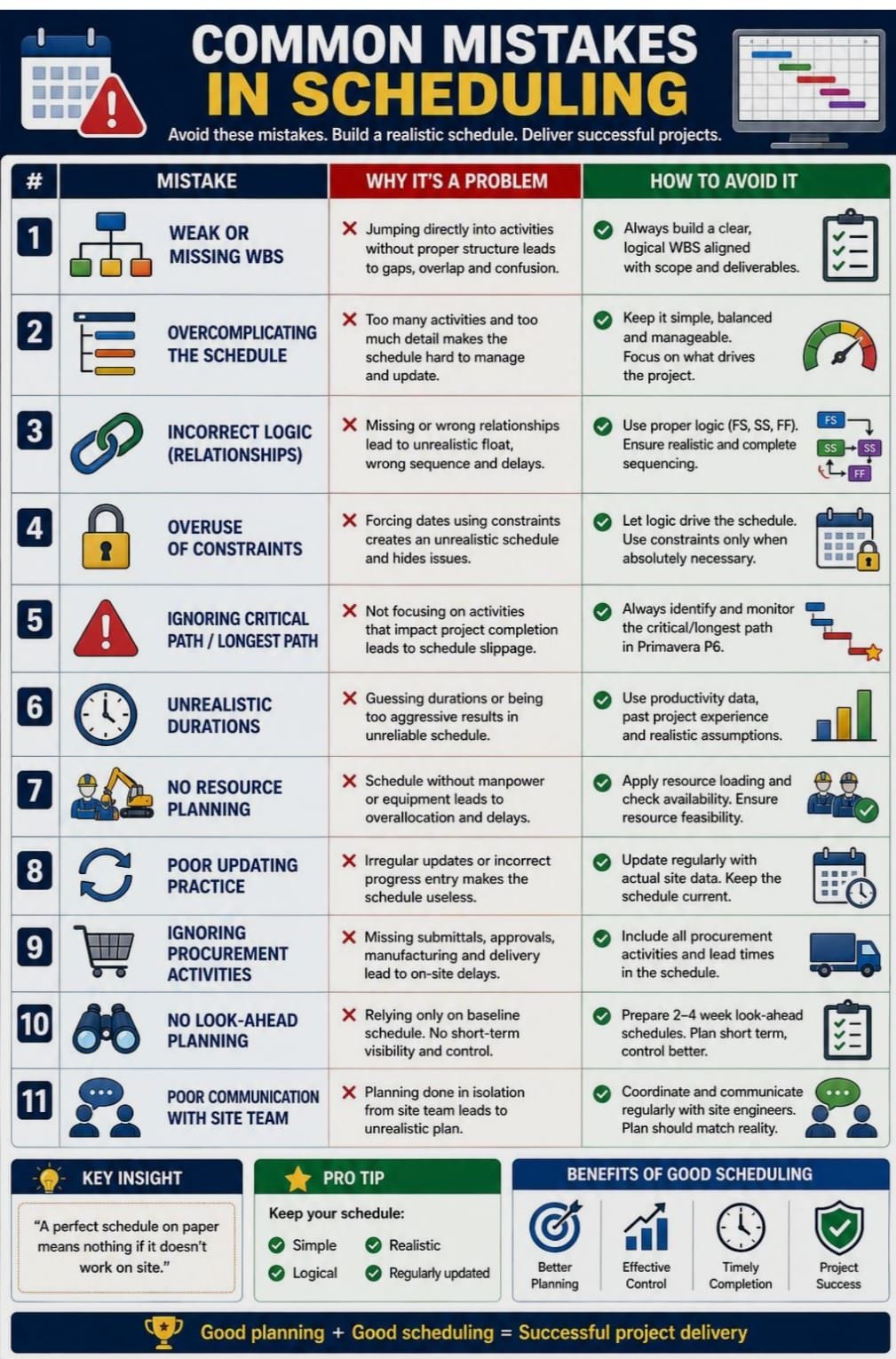

Ivaldo Monteiro and Arsalan Adil built a great cheet sheet around the most common mistakes in scheduling projects.
Image credit: Attributed to Ivaldo Monteiro and Arsalan Adil by Ricardo Viana Vargas.
But the real lesson is in Ricardo Viana Vargas’s post that highlighted this cheat sheet.
…scheduling in project management is often treated as precision work, when in reality it is about managing uncertainty.
Pause, and think honestly for a moment, how often you have worried that a project schedule is accurate? How much time did you invest in trying to get the team to give you accurate estimates so you could be sure your schedule was right? How much energy did you focus on making your schedule detailed and pretty?
These are all precision habits.
If we treated the schedule as a risk register and instead looked at all the ways things might go wrong and planned strategies to mitigate those events, the schedule output of that exercise would be far more valuable and probably more accurate to how things will unfold.
A common scenario I have encountered is project managers who ask me how to plan their agile project. The key problem of course being that if you are used to having estimated durations, an agile project can present a whole new level of ambiguity and unknowns.
My answer to this is, just plan timeboxes. Let’s say for example, the team will iterate in two-week cycles. You have 16 weeks until the project deadline, so you have 8 timeboxes.
What’s the goal to be achieved in each timebox that builds toward the project outcome?
A schedule is only useful if it reflects how the project is actually being built, not how we wish it would be built.
After you’ve planned your timeboxes, then look at what happens if those goals aren’t achieved. That might change your commitments or it might give you a narrative for your stakeholders to ensure expectations are managed. Either way:
…simplicity wins over complexity
Because in the field, clarity is what drives execution... not detail.
